West Asia Crisis Delays Housing Projects; Centre Allows Four-Month RERA Deadline Extension

MoHUA allows four-month RERA extension for eligible delayed housing projects due to West Asia crisis, while homebuyers question regulatory relief.

By
TRT Editorial
TRT Editorial is your early-morning voice for the latest headlines. With a sharp eye for current events and a passion for clarity, TRT Editorial delivers concise, engaging...
6 Mins Read

The Ministry of Housing and Urban Affairs (MoHUA) has ordered each Real Estate Regulatory Authority of state, the RERA, to provide four months of extension for registration and completion deadlines of real estate projects which are eligible and facing delays because of the war situation in West Asia. This notice has been circulated to give some interim relief from the regulations that would delay the opening of the real estate development sites that have their delays in part due to disrupted supply chains. The advisory aims at allowing the developers time to overcome the current crisis Still they have to ensure that they do not dilute the provisions of the Real Estate (Regulation and Development) Act, 2016 (RERA).

Extension Based on Force Majeure Provisions Under RERA

The said advisory by the ministry comes after the issuance of Office Memorandum by the Ministry of Finance dated April 29, 2026, treating the ongoing West Asia situation as a "war" for the purpose of claiming force majeure in government contracts. Sections 6 and 7(3) of the RERA Act, 2016 were invoked by the housing ministry stating that registration of such projects could be extended in case of war and similar extraordinary circumstances.

Based on the claims submitted by the developers and industry bodies, the ministry states that due to the conflicts in West Asia, there were issues in the supply chain system in terms of shortage of building materials and increased freight costs and import delays.

Eligibility Criteria and General Orders Recommended for Extensions

The advisory recommends that the State RERAs should allow an extension in the validity period of registration along with extension in the completion periods for all such eligible projects where the original, revised or earlier extended date of completion falls on or after February 28, 2026. In order to cut down the procedural delays, the ministry has recommended that the state regulatory authorities issue a general order for extension of the period.

In this regard, the ministry has invoked the provisions of Section 7(3) of the RERA Act, through which the Authority has been authorized not only to revoke project registrations, but if circumstances so warrant, it may decide not to revoke and instead issue conditions to keep the registration alive as long as these are to help with allottees. The advisory is directed at making sure that the disruptions due to international factors do not push such projects into non-compliance just because developers themselves are not the cause of those disruptions.

Developers Welcome Relief Amid Supply Chain Challenges

Major bodies of the real estate sector, Sspecially CREDAI and NAREDCO, have applauded the action and expressed their opinion that it is a relief needed to assist developers in the face of global logistic disruptions and construction material supply issues. These organisations have mentioned that delays in the delivery of imported materials, higher input costs and uncertainties in foreign trade have led to the prolonging of project completion which in turn has given rise to delays of four months for the delivery of completed projects and given all these the delay for such projects would be a practical way to have an orderly completion of the projects while the regulations are followed at the same time.

Homebuyer Groups Raise Concerns Over Regulatory Relief

On contrary, the advisory has given way to sharp reactions from the homebuyer groups, which maintain that developers enjoy the luxury of a one-size-fits-all kind of regulatory help, whereas buyers who have been expecting delivery of their houses for many years have not been extended even a fraction of the protection that has been given to the developers.

The Forum for People's Collective Efforts (FPCE) claimed that this advisory indicates discrimination in treatment of developers and home buyers. FPCE observed that thousands of buyers are paying on home loan EMIs and house rent on monthly basis while they wait for their handoved to be delayed, and no blanket relief has been announced to protect their interest as HT. FPCE Pres. Upadhyay questioned the legal validity of this advise from the ministry, stating, 'Although the notification makes reference to Sections 6 and 7(3) of the RERA Act, it doesn't specify under what section does the Union ministry have the authority to direct all State RERA Authorities to provide blanket extension There is no war like situation in the country and no material has been produced to prove an outright scarcity of essential construction material.

FPCE Questions Applicability of Force Majeure Provision

If such a position is accepted, in the light of international scenario, that any foreign conflict forms a force majeure condition for every real estate project, then developers would be entitled for similar extensions, the moment, any foreign trouble erupts and disturbs world markets'. The homebuyers' body highlighted that while the project completion timelines are set by the developers themselves, several projects already have timelines of up to five years or more.

It reasoned that, given the duration involved, commercial risks are possible only on short term, and in such a case, delivery expectations should be reasonable enough to factor in supply chain disruptions and logistical hiccups. FPCE queried as to why, Beyond real estate, no other industry was looking to seek blanket regulatory comfort when none other than real estate claimed 'its contractual obligations cannot be honored because of the west Asia situation'.

Concerns Over Compensation Rights Under Section 18 of RERA

Developments under Section 18 of the RERA Act, which entitle homebuyers to compensation from developers for delays in the delivery of their flats, is one issue the homebuyers highlighted. As FPCE, although the government has moved swiftly to assist developers, a general advisory has still not been issued asking builders to directly adhere to Section 18 and financially compensate affected buyers. As a result, homebuyers carry out long judicial processes with RERA authorities and courts to enforce their statutory rights through the courts. The organisation also pointed out that this extension is the second major blanket measure following the lockdown period due to the pandemic and that the Centre has time and again come to developers' rescue while homebuyers were left in limbo to find out an individual solution to their problem after waiting for years for their possession.

Impact on Homebuyers and Project Delivery Timelines

This advisory might mean a four-month delay more at least for homebuyers in their possession delivery. Those homebuyers who had already envisioned moving into their flats and ending rentals or who were basing their financial commitments on earlier completion dates may now have to make changes to their planning again. And, because of the delay, they would be required to spend more on rent as well as making their ongoing home loan repayments.

Supply Chain Disruptions May Affect Housing Completions in 2026

Market experts suggest the geopolitical scenario is not likely to be very different and could continue affecting project execution throughout 2026. As per Anarock report, if the unrest in the Middle East continues for quite a long time the housing project delivery schedules will be severely affected in the form of the breakdown of supply chains and the increase in construction costs. In 2020, when the country was under lockdown due to the coronavirus, only 2.14 lakh homes were delivered against a target of 4.66 lakh homes. This shows how a major disruption can negatively affect housing completions.

The Mumbai, Pune and Bengaluru trio makes up almost 70% of the home completions expected in 2026 as per this report. So if the problem of the supply chain continues, these cities will be hit the most on delays. Around four months extension of the time period of completion of those eligible Projects whose scheduled completion date/s falls on or after February 28 2026 has been already announced by Telangana Real Estate Regulatory Authority ( TG - RERA ), who followed the guidance of the Centre. Similar notifications are anticipated from State RERAs of other states, in the next few weeks.

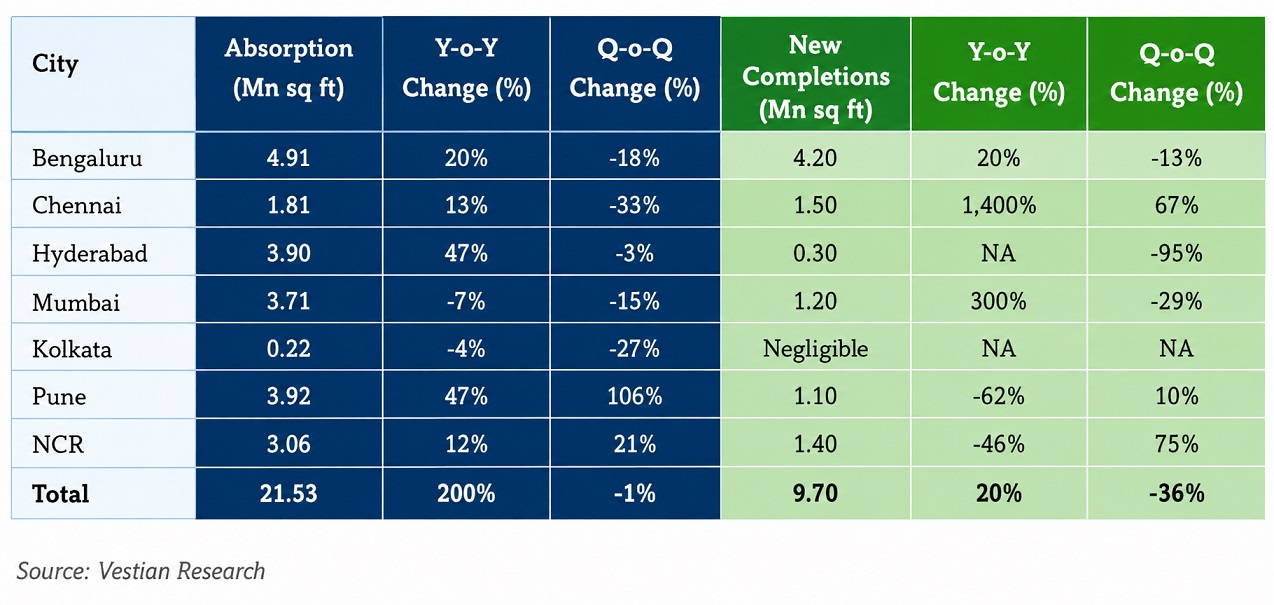

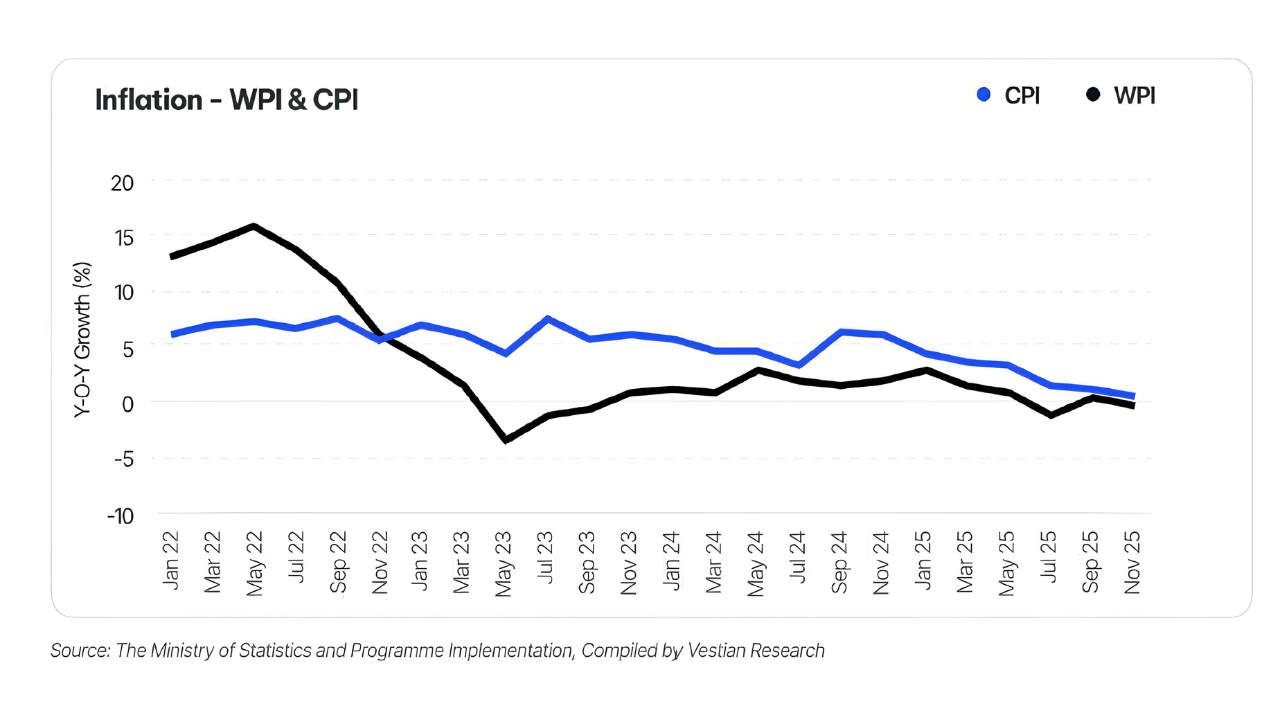

As per Vestian report, new completions declined sharply by 36% quarter-on-quarter to 9.7 Mn sq ft in Q1 2026, the lowest level recorded in the past four quarters. Bengaluru, Hyderabad, and Mumbai cities contributed significantly to this decline as developers adopted a cautious stance amid prevailing uncertainties. For instance, new completions contracted sharply in Hyderabad to a mere 0.3 Mn sq ft in Q1 2026 compared to 6.0 Mn sq ft in Q4 2025, registering a decline of 95%.


State RERAs Expected to Implement Extension Advisory

In fact, the advisory of the Center has been expectedly most effective in places where there are a huge number of housing projects. Only Uttar Pradesh has about 1199 projects that can take advantage of the extension of time, including 301 projects in Noida and 148 projects in Ghaziabad. The rest of the major real estate markets have probably similar types of relief provided.


Balancing Developer Relief and Homebuyer Protection

The recent announcement demonstrates the government's initiative to safeguard large scale infrastructure projects in the country from being affected by unexpected international happenings. Developers But accept the extension of timelines as an inevitability so that the construction work does not halt in the face of supply chain bottlenecks. Yet again, this move throws up the issue of the tension between providing relief to the construction sector regulators and ensuring that homebuyers are adequately protected through stringent housing laws. With increasing number of State Real Estate Regulatory Authorities putting this order into effect, we can expect more and more legal aspects and project delivery issues, consumers' rights, as well as confidence in the market will be intensely monitored in the near future.
